Construction

Seek truth, be pragmatic, forge ahead,
Be loyal to duty, dare to contribute

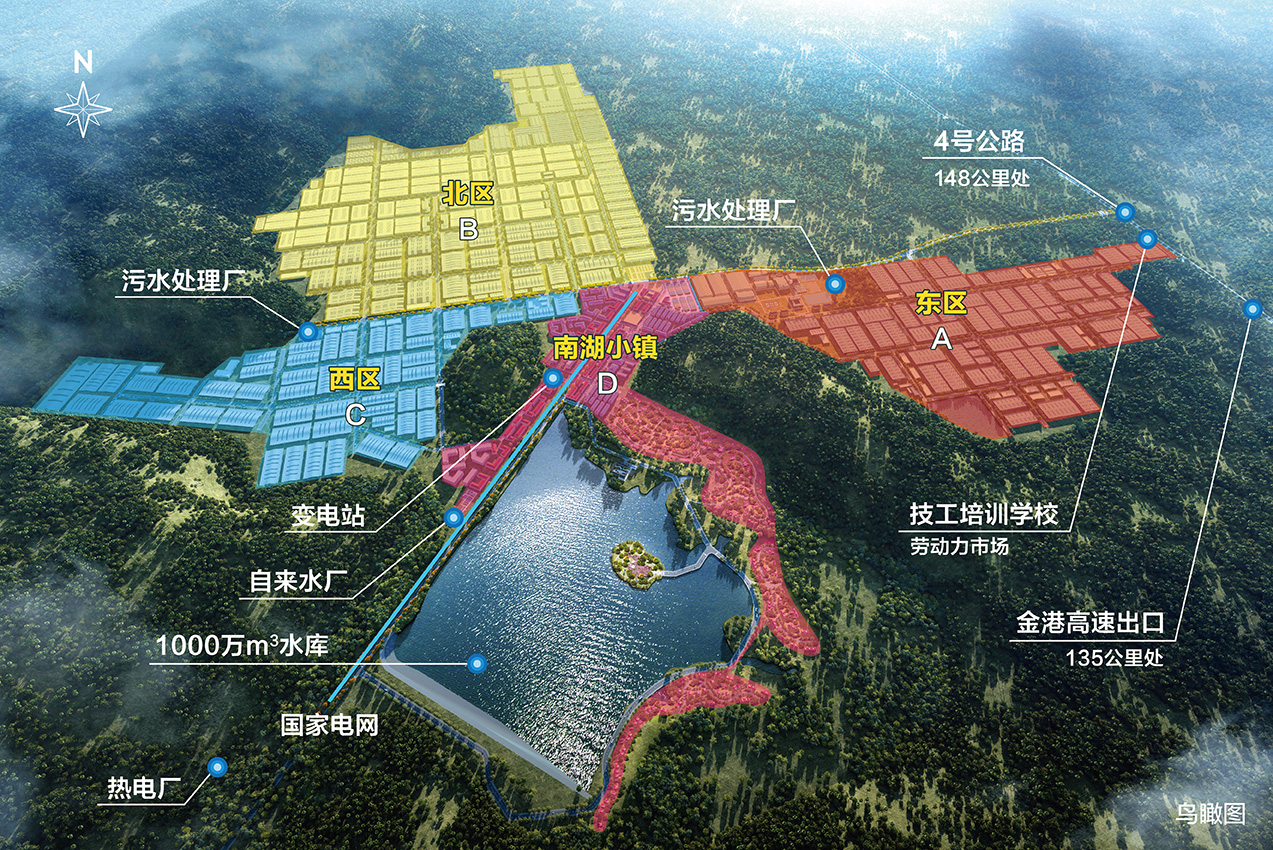

Construction And OperationFour major zones
  • 【East District】

    Including furniture, sofas, luggage, building materials, stationery, textiles, packaging, and printing factories. Constructing a sewage treatment plant

  • 【North District】

    Including hardware tools, printing and dyeing factories, home appliance factories, electroplating industrial parks, etc

  • 【Western District】

    Various chemical and pharmaceutical companies. Constructing a sewage treatment plant

  • 【Nanhu Town】

    Build a commercial district in Nanhu Town centered around a 10 million m ³ capacity reservoir.

Construction And OperationComprehensive supporting facilities
  • Ten complete industrial supporting facilities:Water supply, power supply, steam supply, sewage treatment, packaging, logistics park, technical school labor service, maritime terminal, administrative and legal services, electroplating industry park

    Ten comprehensive living facilities:Supermarkets, shops, farmers' markets, dining and entertainment, schools, banks, hospitals, hotels, apartments, residential areas

  • Self built reservoir:

    Land occupation:100 hectares
    Capacity:10 million m ³
    Scale:The largest water supply capacity among Cambodia's special economic zones

  • Self built water supply plant:

    Scale:30000 cubic meters per day
    Source of water:Using surface water
    Standard:Chinese drinking water standards
    Quality:Professional water quality treatment

  • Self built sewage treatment plant:

    Light Industry Zone: 15000 cubic meters per day, under construction, planned to start production in October
    Chemical Industry Zone:Planning and Design in Progress

  • Power and steam supply:

    Grid power supply:Adopting power supply from the national grid in Phnom Penh, the capital city, to ensure dual power supply, stability and reliability
    Power generation, power supply, and steam supply:Plan to build a self built power plant with guaranteed electricity and steam supply

  • Shipping Terminal:

    Sihanouk Port:60KM away from the second phase of the special zone, 10000 ton dock
    OMP Pier:8KM away from the second phase of the special zone, 5000 ton dock

  • Worry free electricity protection and escort

    The SEZ plans to construct a new scale 400MW biomass power plant with a total investment of 340 million US dollars. The first phase is expected to invest 200 million US dollars, and the project has entered the preparation stage.
    After the completion of the power plant, enterprises will no longer worry about power outages and can arrange production plans with peace of mind to ensure timely delivery of products.

  • The dry dock is about to go online:

    The special zone has officially launched the construction of a dry dock covering an area of 43446 square meters, shifting the port function inland and directly bringing the port and enterprises 60 kilometers away closer.
    After the dry dock is expected to be put into operation at the end of May, it will directly exempt enterprises from $100/container container container handling and transportation fees, empty container return fees, as well as customs clearance and license application fees, which will also decrease by about $100/container. The logistics cost of a single container for enterprises will also decrease by about $200.

  • International School

  • Cambodian Apartment

  • Commercial town

  • Administrative Service Center

  • Zhongjiang Hospital

Construction And OperationEngineering progress
  • Rapid progress of basic supporting projects

    1. Main roads in the park:The total length of the planned road is 54.3 kilometers, and 12 roads have been poured since August 2023, with a cumulative mileage of 20 kilometers.

    2. Municipal pipeline network:The rainwater, sewage, and water supply pipe network has accumulated 8KM.

    3. North District Earthwork Project:The 2.2 million m ³ first section earthwork project started on November 28, 2024, and the 2.2 million m ³ second section earthwork project started on December 6, 2024, and is expected to be completed by the end of May 2025.

    4. Reservoir dam:Construction started in January 2024 and was basically completed in June, successfully storing over 8 million cubic meters of water.

    5. Waterworks:The design scale consists of 6 integrated modules, with a daily supply of 30000 m ³/d of tap water. It will be put into normal use by the end of November 2024.

    6. Sewage treatment plant:The daily treatment capacity of industrial wastewater is 15000m ³/d, and it is planned to be put into use by the end of August 2025. The integrated sewage treatment facilities in the eastern district are under construction and are expected to be put into use by the end of June 2025.

    7. Opening and closing station:Two closed power stations have been built and put into use to ensure the daily production and living electricity needs of the settled enterprises.

    8. Lakeside Hotel:The total construction area is 5500 square meters, and it is planned to have 50 guest rooms, convenience stores, catering, coffee shops and other functions. It will be put into use by the end of March 2025.

    9. Skills training schools and labor service centers:The center covers an area of 1200 square meters and has been put into use.

    10. East Gate:The entrance of the East District will be completed in December 2024, and the opening ceremony of the East District will be held at the gate of Hangzhou Street on January 15, 2025.

    11. Kasen Courtyard:Covering an area of 12000 square meters, it was launched in early July 2024 and completed and put into use on January 10, 2025.

  • Rapid progress of factory construction projects

    1. Self built standard factory buildings in the SEZ:

    Eight buildings have been built with a total construction area of approximately 120000 square meters, all of which have been signed for lease and put into use.

    2. Construction of contracted enterprise factory:

    Hanlin Sofa Factory, Frontier Pharmaceutical Factory, Sulfuric Acid Factory, Fine Chemicals, Cultural Supplies Factory, Universal Steel Structure, Packaging Factory, and Jiuchongtian Hotel all started construction in the first half of 2024 and will be put into operation by the end of March 2025, with Jiuchongtian Hotel opening;

    About 40 enterprises, including electroplating industrial park, gelatin factory, wooden door factory, industrial protein factory, glue factory, Dingli Construction, furniture factory, hardware and auto parts factory, power equipment factory, cardboard packaging, etc., have started construction. Among them, nearly 20 enterprises will start construction around the Spring Festival in 2025.

    More than 30 enterprises, including lead smelters, eyewear factories, hardware tool factories, warp knitting factories, smart home factories, and home appliance factories, are about to start construction.

    3. Signed enterprise put into operation:

    The first phase of Hanlin Sofa Factory started construction on March 5, 2024 and was officially put into operation on November 10, 2024;

    Aibo Furniture and Wentong Furniture will officially start production in December 2024;

    Junjie Pet, Brother Hardware, Fine Chemicals, Sulfuric Acid Factory, Jiuchongtian Hotel, Yuchuang Luggage, R HOME Furniture, Hualian Group, Khmer Furniture, Hengchang Packaging, and Lebang Furniture will all be officially put into operation in the first half of 2025.
